The DIGS Journal
Permitting & Process12 min read

Can You Build an ADU on a Septic System?

By Eric Dexter, Owner & Builder ·

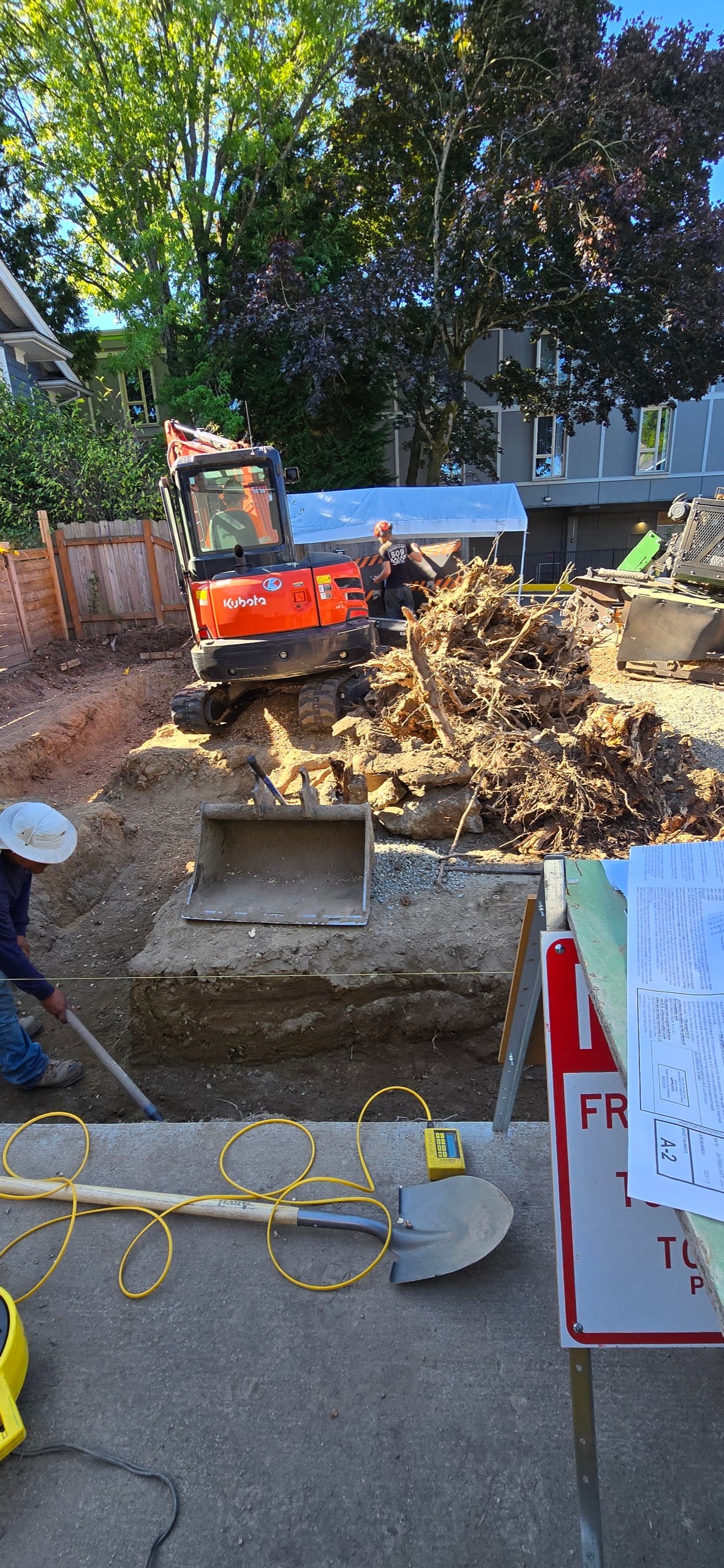

Open utility trench running to a detached ADU under construction on a DIGS Construction site

Short answer: usually yes — but on a septic lot the county health department decides it before the building department ever opens your plans. In both Snohomish and King County a septic approval is a prerequisite for the building permit, not a parallel task you sort out later.

That changes the order of operations. On a sewer lot you can design the cottage and then solve utilities. On a septic lot the system's capacity, the location of its reserve area and the setbacks around both decide where the building can physically go — and occasionally whether it can go anywhere. The good news is that all of it is knowable early, cheaply, and before you spend money on plans.

Rules below are the state on-site sewage system code (chapter 246-272A WAC, rewritten effective April 1, 2025), King County Board of Health Title 13 (effective April 1, 2025) and the Snohomish County Board of Health code. Fees are the published schedules current as of October 2026. Your parcel is governed by one specific health jurisdiction, and their reading of their own code is the one that counts.

The health department goes first

This is the single most useful thing to understand about building on septic, and it is the thing most homeowners learn a month too late.

Snohomish County: the construction clearance

Before Planning and Development Services will issue a building permit for any development on a septic parcel, the Snohomish County Health Department has to issue a construction clearance, submitted through the PDS portal. The clearance is the health department's statement that the existing system can serve what you are proposing, or that an approved plan exists to make it serve.

The legal hook is the county's remodeling-approval rule: additions and alterations have to be served by a system that complies with the state code. It can be waived only where the work is compatible with the system and its reserve drainfield area, the system is adequate for the remaining useful life of the structure, and continued operation will not harm public health or surface and ground water. The department weighs a defined list of factors — it is a judgement, not a checkbox.

The county's own ADU guidance sorts every project into one of two scenarios, which is a useful way to think about your lot:

  • Scenario A — the drainfield is too small for the added flow. The options are connecting to public sewer, enlarging the drainfield (with or without a separate tank), or installing a whole separate system for the ADU. All of these require a permit and a licensed designer.
  • Scenario B — the system is already sized for it. The designer decides whether a separate tank is needed. If it is not, the ADU connects with no septic installation permit at all — though the construction clearance is still required.

Scenario B is more common than people expect, because a three-bedroom drainfield serving a two-bedroom house has headroom built in. Which is exactly why the first step is reading your as-built, not pricing a new system.

King County: one sentence that answers the whole question

King County Board of Health Title 13 is unusually direct about it. An ADU may connect to a system designed for a single-family residence “provided that public health and groundwater quality are not affected, and the OSS is designed for the anticipated increased flow” — with every bedroom in the ADU counted toward the total, and a no-bedroom studio ADU counted as one bedroom.

So in King County the question is not whether sharing is allowed. It is. The question is arithmetic.

The arithmetic: design flow per bedroom

Septic systems are not sized by square footage or by headcount. They are sized by bedrooms, through a number called design flow.

The state code builds it up from 45 gallons per person per day, two people per bedroom, times a 1.33 surge factor — which lands at a minimum of 120 gallons per day per bedroom, with a floor of 240 gallons per day for any system. The code expressly addresses our situation: there is a provision for “a single-family residence with one additional dwelling served by the same OSS,” where the additional dwelling adds 120 gallons per day per bedroom. Three or more dwellings on one system get a different rule — 240 for the first, 120 per bedroom for each additional — plus a required easement or covenant.

King County sets its own number higher. 150 gallons per day per bedroom, with a three-bedroom minimum for a single-family residence, and 150 per ADU bedroom where the ADU shares the house's system. An ADU on its own separate system is sized at a two-bedroom minimum. A March 2025 technical memo relaxed the figure for bedrooms past the third in the main house to 120 gallons, but it did not change the per-ADU-bedroom number.

Run it on a real lot. A King County house with a three-bedroom system, adding a one-bedroom DADU: the house already uses its 3 x 150 = 450 gallons per day, and the ADU bedroom adds 150, for 600. Unless the existing system was designed for four bedrooms, that is Scenario A and the drainfield has to grow. A house with a four-bedroom system and only three bedrooms built has the capacity sitting there already.

This is why the as-built drawing is the most valuable document on a septic lot. In Snohomish County the as-builts live in the OnlineRME database and the bedroom count the system was designed for is printed on the cover page. Finding that number costs a free afternoon, and it tells you which scenario you are in before anyone is paid anything.

What counts as a bedroom — including the one you call an office

Homeowners lose this argument constantly, so it is worth being blunt about it.

King County defines a bedroom in code: a room used for sleeping that has a window, a door and a closet, excluding a room under 70 square feet with a closet, and excluding an entryway with a closet. That is a reasonably objective test.

Snohomish County's health department takes the broader view, counting any room that could be used for sleeping — dens, lofts, offices, bonus rooms. If you are anywhere near a capacity threshold, do not design a flex room and hope the label on the drawing carries you. Ask the department how they will count it, in writing, before the plans are final.

The practical consequence: a studio DADU is usually the cheapest thing you can put on a tight septic system, and a two-bedroom DADU with a loft can quietly be a three-bedroom load.

Setbacks and the reserve area — the part that moves the building

Capacity is the first constraint. Geometry is the second, and it is the one that actually relocates cottages on site plans.

Every system has a dispersal component and a 100 percent reserve area — undeveloped land held in trust for the day the drainfield fails. State setbacks are measured from both. The ones that shape a DADU site plan:

  • Well: 100 feet from the dispersal component and from the reserve area.
  • Building foundation: 10 feet. This is the number that pushes a cottage off the obvious flat spot in the yard.
  • Property or easement line: 5 feet.
  • Surface water: 100 feet.
  • Septic tank to a building foundation: 5 feet.
  • Building sewer to a foundation: 2 feet.

Two failure modes come up again and again. The first is a reserve area that was never recorded clearly, so nobody knows where it is until a designer re-establishes it with soil logs. The second is worse: a reserve area that has already been built over, paved, or had its setbacks encroached by a shed or a parking pad. King County is explicit that in that case the reserve is no longer an approved reserve and has to be re-designated elsewhere on the lot, with new soil logs. On a small lot there may be nowhere else, and that is a hard stop rather than a cost.

It is the same reason grading and drainage deserve attention early rather than late — we go through that in site work, grading and drainage on a DADU build.

If you are on a well too

Septic and well usually travel together, and the well has its own gatekeeping.

State law defines a public water system to exclude a system serving only one single-family residence — so a house plus an ADU is two residential service connections, which makes it a Group B system by definition. The state then hands one- and two-connection Group B systems back to the local board of health, which is where the real requirements live.

In Snohomish County, a well serving one or two single-family units is an “individual water supply,” and three things have to be on file before a building permit issues: an approved well site inspection; an accepted Request for Review showing code-compliant construction, potable water and a yield of at least 400 gallons per day per connection — 800 gallons per day total — and a recorded Declaration of Covenant for a Two-Connection Well. If the well cannot demonstrate the yield, the answer is a new well or public water.

King County is tighter on new private wells: a well is an approved source only on a lot of at least five acres, or one created before May 18, 1972, with a recorded 100-foot sanitary control covenant, at least 400 gallons per day demonstrated, and clean coliform, nitrate and arsenic results.

One more wrinkle for permit-exempt wells in the Snohomish, Cedar-Sammamish and Duwamish-Green basins: the streamflow-restoration rules set a 950 gallon per day maximum annual average per connection and a $500 fee to the permitting authority. Wells drilled before January 19, 2018 are treated differently. A water-rights question belongs with the county, not with your builder.

Rural lots: the state ADU law stops at the growth boundary

If you have read that Washington now requires cities and counties to allow two ADUs per lot, here is the catch that applies to most septic lots: that mandate only applies inside designated urban growth areas. The statute says so in plain terms. It also says nothing in it requires an ADU where development is restricted by proximity to on-site sewage infrastructure or critical areas, and it expressly lets a jurisdiction prohibit ADUs on lots not connected to or served by public sewers.

So outside the growth boundary you are back on local rules, and both counties are more restrictive there:

  • Snohomish County: urban zones allow two ADUs in any combination; rural and resource zones allow one. A detached unit is prohibited where the lot does not meet the zone minimum lot area, and specifically prohibited on R-5 lots under 5 acres and RC lots under 100,000 square feet. Rural ADUs are capped at 1,200 square feet, must share the house driveway, and the applicant has to document septic capacity.
  • King County: urban areas allow two ADUs; rural and resource zones allow one. A detached unit is allowed only where there is no more than one primary unit and the lot meets the zone minimum — 1.875 acres in RA-2.5, 3.75 acres in RA-5, 7.5 in RA-10, 15 in RA-20. No ADUs in the forest zone, and attached only in the agricultural zone. A notice identifying the unit as accessory has to be recorded against the land before the permit is approved.

There is a newer option on the horizon. A 2026 state law created a permissive path for counties to allow one detached ADU per parcel outside growth areas — with water-availability evidence, metering of each dwelling, documented septic capacity, a 1,296 square foot cap, the same driveway, siting within 150 feet of the principal unit, and no eligibility for nonconforming lots under an acre. It took effect in June 2026. It is an option counties may adopt rather than a requirement, and we have not found an adopting ordinance in either Snohomish or King County as of October 2026. Worth asking about if your lot is rural and otherwise disqualified.

Inside the King County urban growth area the opposite pressure applies: development is supposed to be on public sewer, and an on-site system is allowed only on an interim basis with a recorded certificate of future connection.

Monroe: inside the sewer envelope this is not a septic project

Worth stating plainly, because it saves a lot of wasted research. Monroe's municipal code requires connection to a public sewer where one runs within 200 feet of the property line, and makes constructing a new septic system unlawful in that situation. So for a large share of lots in Monroe, a DADU is a sewer connection project rather than a septic one — generally simpler and more predictable.

Monroe's ADU rules themselves are permissive: up to two ADUs, sized at the larger of 1,000 square feet or 50 percent of the principal unit excluding the garage, one parking space unless the lot is within a half mile walking distance of a major transit stop, no owner-occupancy requirement, and ADUs may be subdivided or segregated in ownership.

What it costs to find out

These are published health-department fees only — not design, excavation or construction. They are what it costs to get answers.

Snohomish County (schedule effective November 1, 2025): building clearance review $470; GMA drinking water determination $150; as-built and reserve-area designation performed concurrently with the clearance $235; alteration of an absorption system or reserve $480; tank only $390; repair of a single-family system $390; new gravity or pressure system application $1,130 plus a $385 installation permit; hourly rate $235.

One timing note worth acting on: a Board of Health ordinance raises these on November 1, 2026 — the clearance review to $550 and the new-system application to $1,185. If you are close to submitting, the next few weeks are worth something.

King County (effective January 1, 2026): a new building with plumbing is $338 for the application plus $450 for the inspector, so $788 — the same whether or not there is an approved record drawing on file. King County also requires a maintenance inspection report dated within the last twelve months, and is explicit that a pump-out is not a maintenance inspection. Design approval is good for three years.

Design itself has to be done by a professional engineer or a licensed on-site sewage system designer. That is a code requirement, not a preference — a builder cannot sign it, and neither can you.

What we deliberately will not do is quote you a drainfield expansion cost. It depends entirely on soil type, available area, whether gravity works or the site needs pressure distribution, and how far a new field sits from the tank. Anyone quoting that number without a soil log is guessing. For the parts of an ADU budget that can be scoped honestly, see realistic costs and the ADU cost calculator.

The order of operations that saves money

  • Pull the as-built. Snohomish records are in OnlineRME; King County records come from Public Health. Read the bedroom count the system was designed for.
  • Do the arithmetic. Existing design flow versus house bedrooms plus ADU bedrooms, at 120 gallons per day per bedroom in Snohomish or 150 in King County. That tells you Scenario A or B.
  • Locate the reserve area on a site plan, and walk the lot for anything built over it.
  • Apply the setbacks — 10 feet off a foundation, 100 feet off a well, 5 feet off the lines — and see what buildable area survives.
  • If you are on a well, start the yield and covenant paperwork early; it is sequential, not parallel.
  • Only then design the cottage. A floor plan drawn before this is a floor plan that may have to be redrawn.

We run this sequence at the feasibility stage on every septic lot, because the alternative is designing something that cannot be permitted. If you want to know where your lot stands before spending money on plans, start with whether your lot can take an ADU at all, then read the ADU rules for Snohomish and King County for the zoning side of the same question. The utility side — water, sewer, power and what those connections actually involve — is covered in ADU utility connections.

DIGS builds ADUs, DADUs and custom homes across the greater Seattle area, including a good number of septic lots in Snohomish County. If you are on septic and want a straight answer about your parcel, the feasibility conversation is the right starting point — bring your as-built if you have it.
